MTU wants to use deep geothermal energy as a source of energy at its site in Munich-Allach. The goal of our company climate action strategy is to reduce our carbon footprint. As a sustainable energy source, geothermal energy is an important component of our climate strategy at this location. Based on preliminary studies, we assume that we could cover about 80 percent of our heating requirements on-site with thermal water. This page explains how geothermal energy works and what we already know about the geothermal deposit in Allach.
Current status:
Drilling for deep geothermal energy
Drill path 1: length 2.650 meter
Drill path 2: length 3.100 meter
Geothermal - phase: 1 From planning to completed drilling
Project diary

Topping-out Ceremony for the Heat Distribution Center

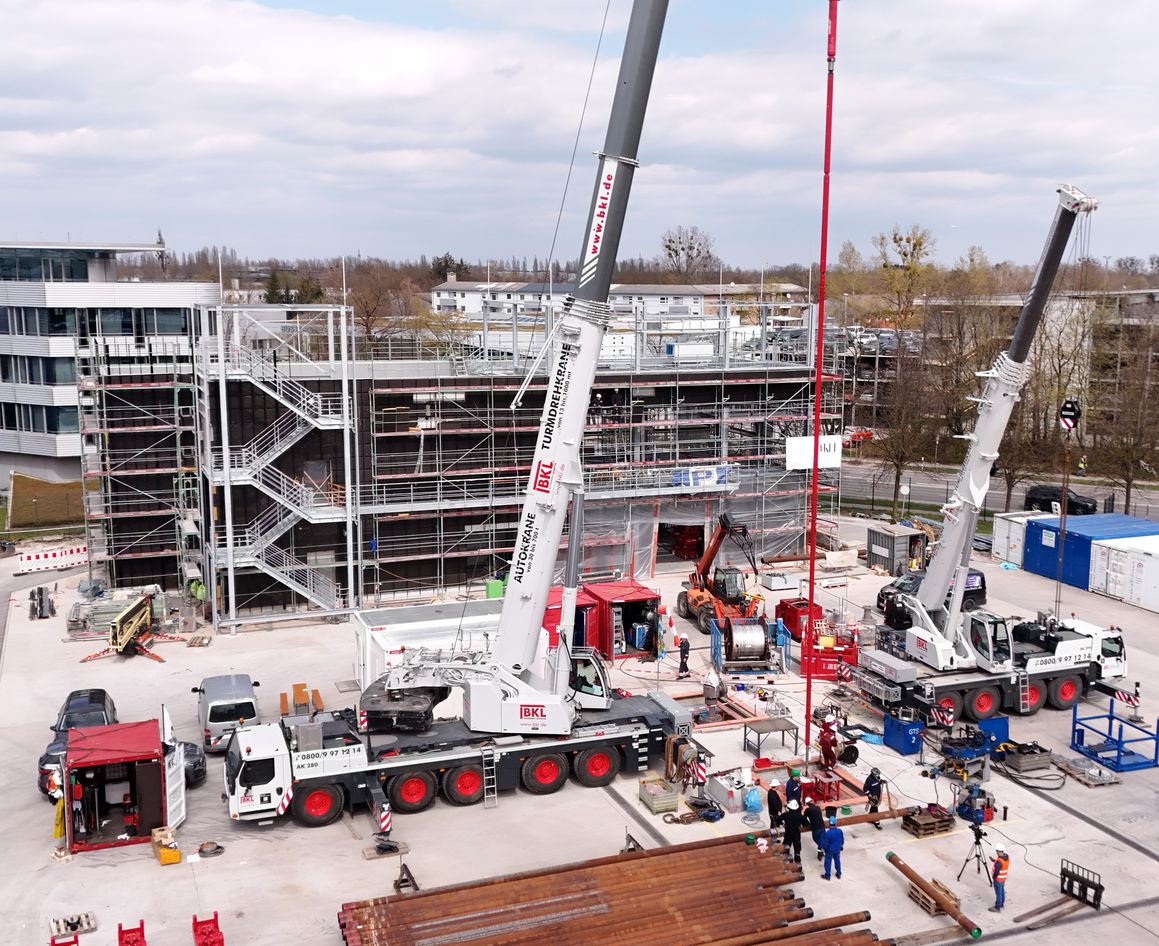

Munich, February 13, 2025 – Construction of the technical building for deep geothermal energy is progressing well. The project team is celebrating the next milestone with the topping-out ceremony and is on the home stretch for commissioning this summer. The heat distribution center will serve to feed the heat from the earth into MTU's heating network.
For MTU, geothermal energy is not only a forward-looking and particularly sustainable project for self-sufficient energy supply. The building for the heat distribution center also reflects the sustainable approach, for example by using steel produced with particularly low CO2 emissions.
Construction of Heat Distribution Center begins
Munich, 24 September 2024 – The time has come: construction of the heat distribution center at the deep geothermal site has begun. The first prefabricated columns and walls were erected in mid-September. The rectangular technical building will be approximately 35 meters long and 11 meters wide. The parapet, an extension of the outer wall above the flat roof, will be almost 11 meters high.
The main purpose of the technical building will be to feed heat from the deep geothermal energy into MTU’s heating network. Construction of the technical building is expected to be completed by the second quarter of 2025


Dismantling drilling rig and drilling equipment

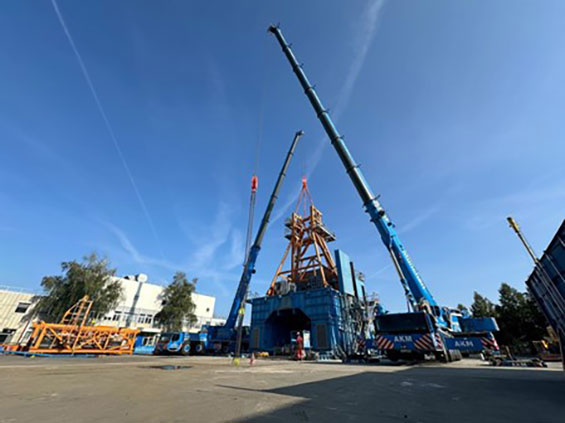

Munich, July 22, 2024 - The 43-meter-high drilling rig on the MTU site has been dismantled after completion of the two MTU geothermal wells and transported away with all the drilling equipment - transformer stations, mud pumps, drilling fluid containers, blow-out preventer, noise protection wall, material and workshop containers.
Three mobile cranes (300 tons and two 180 tons) were in continuous use at times to ensure the smooth dismantling of the drilling rig and its peripherals, loading around 41 trucks to date. The dismantling and loading work was carried out in two shifts, each with five employees.
The drilling site will be cleared again by the end of July and construction of the heat distribution center can begin.
Drilling and testing work successfully completed

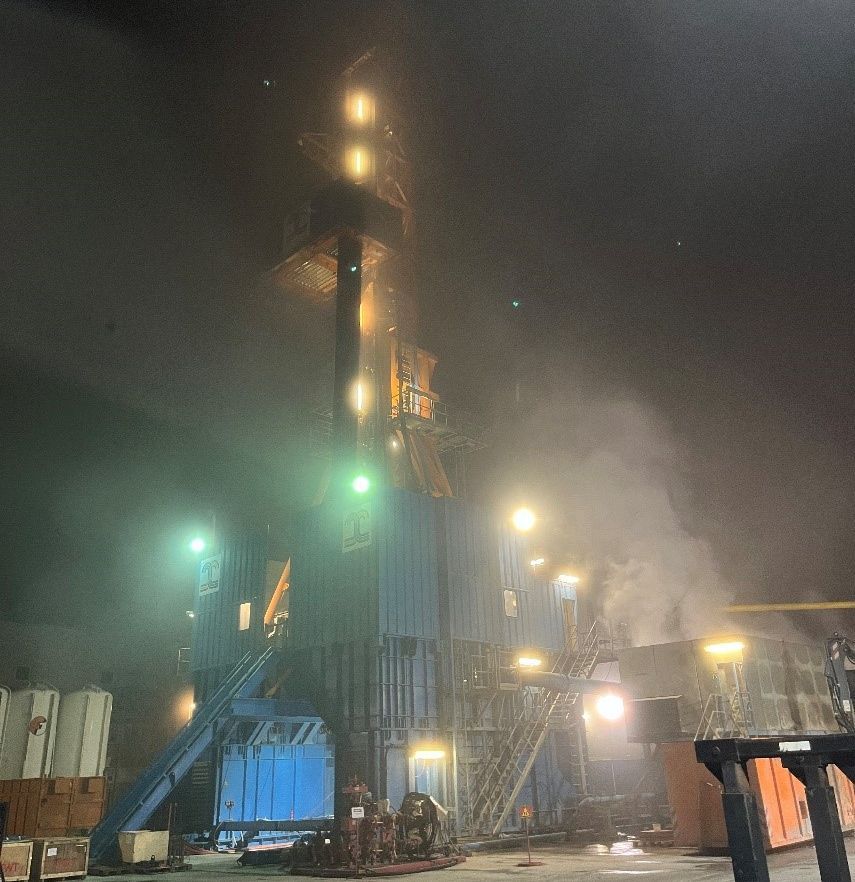

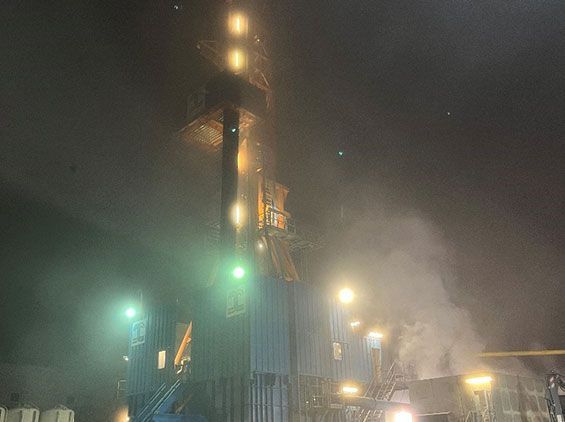

Munich, July 4, 2024 - The drilling and testing work on the two MTU geothermal wells has been successfully completed. "We were able to complete all the work within the set schedule of just under six months," says project manager Stefan Lange. "The pumping tests on the second borehole also showed an extraordinarily good hydraulic yield of over 100 liters per second." The temperature of the thermal water pumped exceeds the 70°C mark. The derrick will be dismantled and the drilling site cleared in July.
MTU plans to start preparatory work for the construction of the heat distribution center at the end of July.

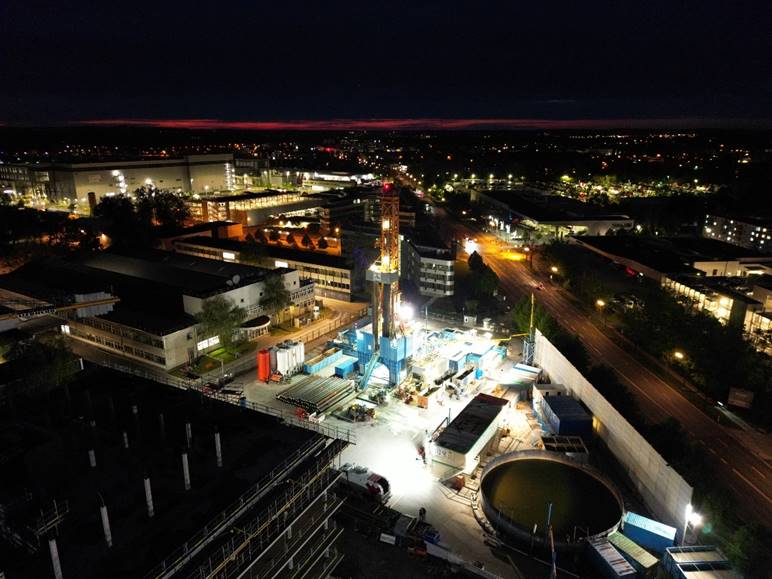

Second drilling path completed
Munich, June 5, 2024 - Done! The last drilling section of the second drilling path has been completed at a depth of around 2,110 meters with a drilling length of 3,104 meters.
MTU has drilled through the Malmkarst over a length of more than one kilometer with an inclination of around 65 degrees. Similar to the first drilling path, the second borehole is already showing very good hydraulic conditions.
In the coming days, pumping tests (so-called production settlement work) will also be carried out on the second drilling path and water vapor clouds may occur again due to the cooling of the thermal water. Once the temperature and yield tests have been completed, it will also be decided which drilling path will be the production or injection well in future.
It all comes down to the bit

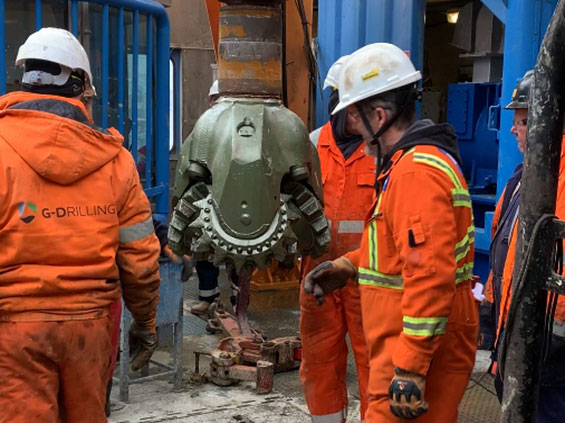

Munich, May 7, 2024 - MTU has already reached a length of 1,530 meters on the second drilling path.
PDC (polycrystalline diamond compact) bits are being used at this depth. Polycrystalline diamond plates are inserted on the wings of the bit as a cutting tool (see photo: dark-colored, circular plates). The right bit is crucial for effective drilling progress: depending on the rock to be drilled through, the contact pressure of the bit on the bottom of the borehole, the rotational speed and the pressure of the drilling fluid must be correctly matched.
As a PDC bit, unlike a roller bit, has no integrated moving parts or bearings, it can continue to be used depending on the load - sometimes even after thousands of meters of drilling. If necessary, individual plates must be refitted.


Start of second drilling path

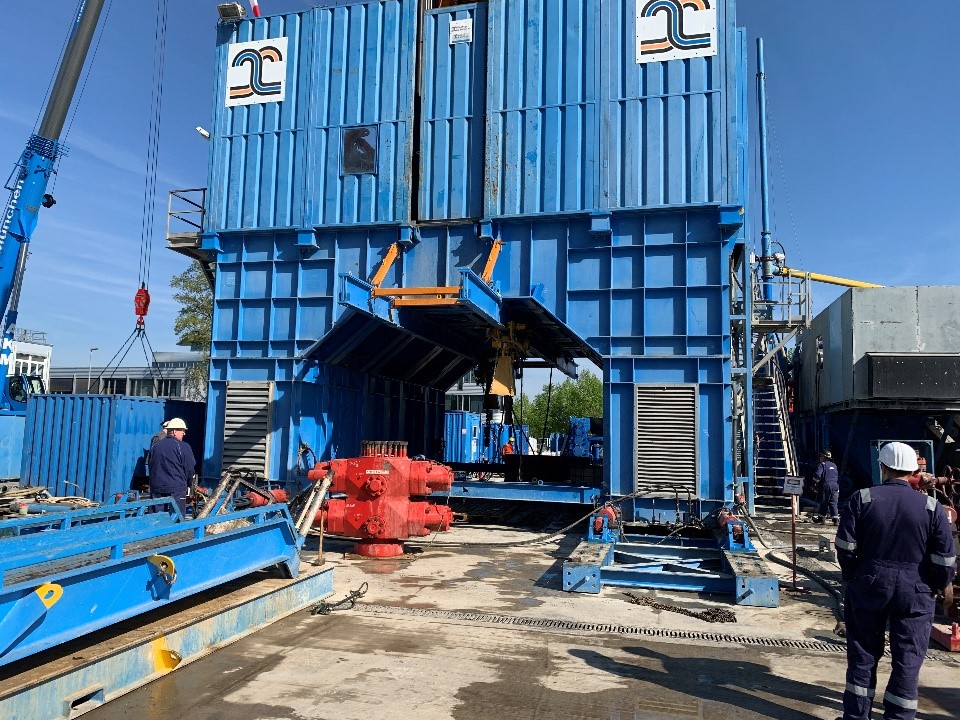

Munich, April 19, 2024 - Last weekend, the 500-tonne drilling rig, already equipped with the drilling equipment, was successfully moved. Four hydraulic jacks were used to move the derrick from the first well to the second drilling location seven meters away. MTU started drilling the second path this week. The drilling path has a north-facing deflection. The planned drilling length is up to 3,100 meters.
.
Important stage reached - successful drilling

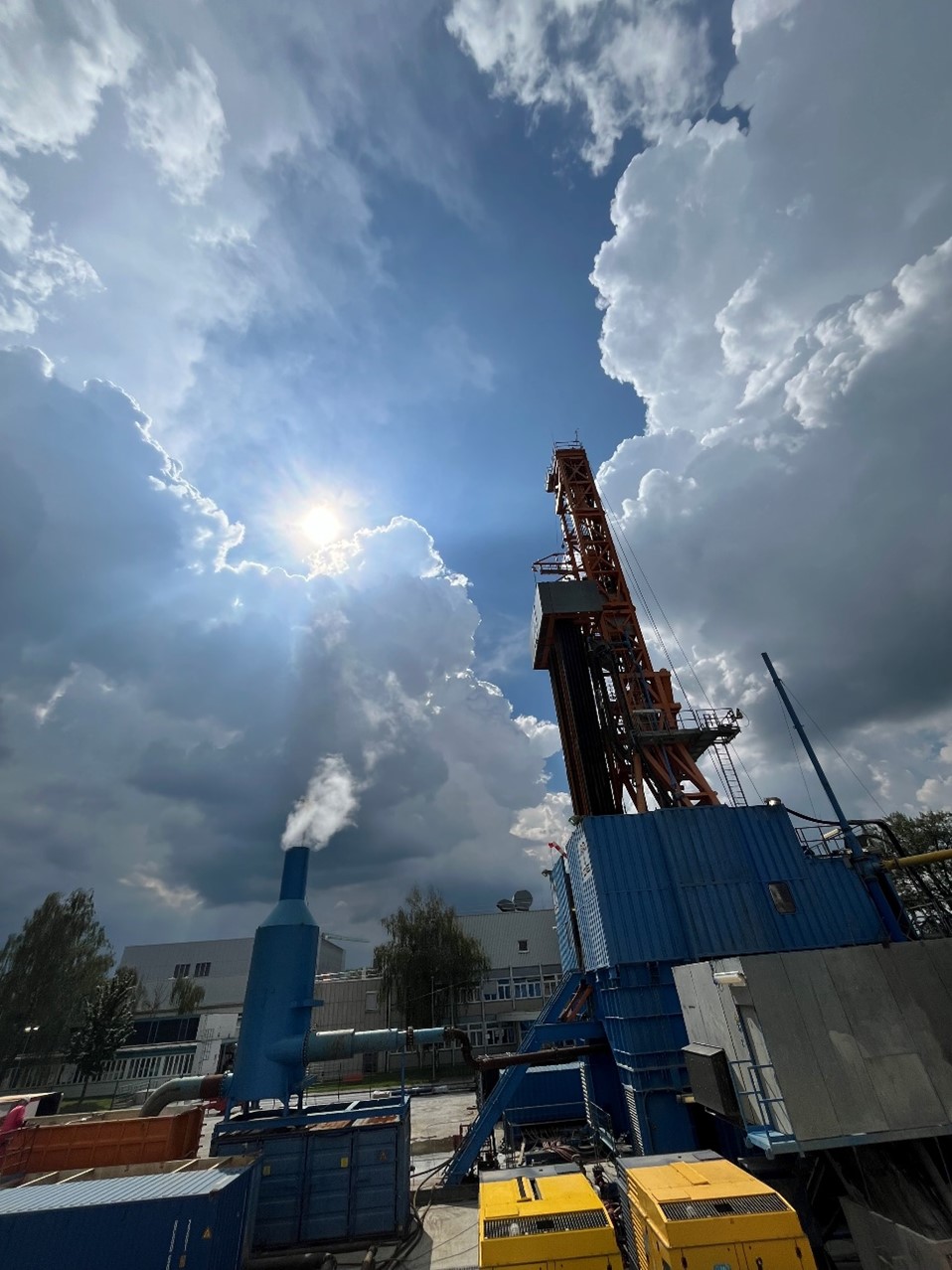

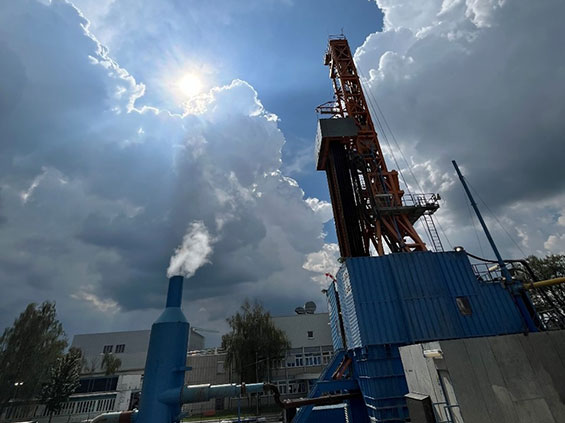

Munich, April 9, 2024 - "It was a significant event when we were able to pump water to the surface from a depth of around two kilometers in the first attempt at the end of March," reports project manager Stefan Lange. "We were all very tense after the intensive and careful preparations to see whether we would find what we expected down there." MTU used the pumping tests to test the yield of the borehole via the amount of thermal water. The excitement quickly gave way to joy with the first steam: "The team is thrilled at how much water could be pumped without lowering the water level too much." The data obtained so far indicates a very productive borehole, with a very good flow rate of well over 100 liters per second and a temperature of around 70°C.


Steam cloud over MTU

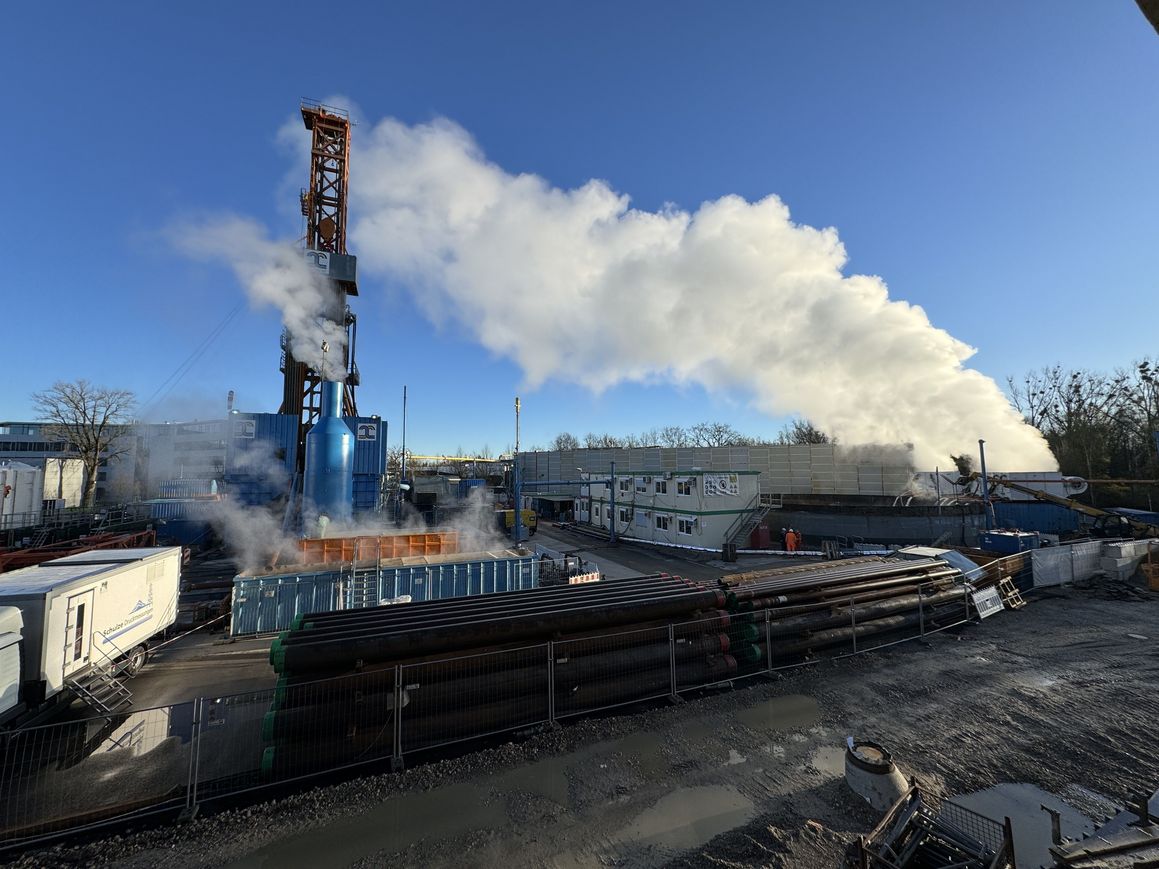

Munich, March 28, 2024 - Steam is currently visible above MTU's geothermal construction site in Munich. The thermal water is currently being pumped up to determine how much water is available in the reservoir. This water must be cooled before it can be discharged into the sewer system. It is cooled down to 35 degrees for discharge into the sewage system. The cooling process produces pure water vapor. During the pumping tests, clouds of steam will continue to form at the site until April 7.
.
Harbingers of the thermal water
Munich, March 18, 2024 - Drilling work on the fourth drilling section is currently underway at a depth of over two kilometers. "We have already reached the thermal water reservoir with a pipe length of 2,600 meters," says project manager Stefan Lange. There are already initial indications of good hydraulic permeability in the drilled limestone and dolomite. "The rock at this depth is highly permeable and completely absorbs the drilling fluid that is added." A good starting point for future production. Once the drilling work for this section has been completed, geophysical borehole measurements and several pumping tests (production settlement work) will follow to determine the reservoir's yield. MTU expects hot thermal water vapor to escape during these tests.


A journey into the past
Munich, March 13, 2024 - The deep geothermal borehole is a journey into the geological past: in the uppermost drilling section, the first 24 meters consist of meltwater gravel from the last ice age (Würm glacial period), several tens of thousands of years old. Below this are molasse rocks, more than 10 million years old. This is followed by sediment layers that were in the transition zone between the sea and the coastline for a long time and contain coal from swamp forests and alluvial wood from coastal forests. The 38-million-year-old molasse rocks end at a depth of around 1,700 meters. Immediately below this are limestones from the Upper Jurassic period (around 145-150 million years old). The borehole currently reaches into the Jurassic limestones ("Malm") at 2000 meters, which form the thermal water reservoir. In the past there was a shallow shelf sea in which limestone formed in a subtropical climate. The thermal water is located in the small cavities in this limestone.
Second section: Drilled and secured to a depth of more than 1.5 kilometers
Munich, February 26, 2024 - After 23 days, MTU has reached the target depth of the second drilling section at around 1,500 metres. The borehole has a diameter of 44.5 centimetres and was drilled to the south at a maximum inclination of 43 degrees using an automated underground directional drilling system. During automated directional drilling, hydraulic flaps mounted directly behind the bit push the borehole in the desired direction. The drilling fluid plays an important role: it serves as a data conduit for the exchange of information between the measuring and directional drilling equipment on the drill string at depth and the engineers on the surface. The second drilling section was secured with steel pipes: They were firmly cemented into the lower, formerly freshly drilled section, after which the casing was extended to the surface. With the start of the third drilling section, MTU has already reached 1700 metres.


Already drilled one kilometer deep
Munich, February 12, 2024 - After ten days of drilling, the target depth of the first drilling section was reached at a depth of around 820 meters on February 1st. The borehole in this drilling section has a diameter of 66 centimetres and was drilled with a slight inclination of around 2-3 degrees to the south. To secure this first drilling section, steel pipes were installed in the following days and then firmly cemented in place.
The second drilling section is currently underway and the drilling depth is over one kilometer. The second section extends to a depth of around 1,500 meters. It is being continued with a smaller drilling diameter of around 44.5 centimetres and a more south-facing deflection.
Karl 1 and 2 seismological stations
The Karl 1 and 2 seismological stations in Karlsfeld have been in operation for MTU since October 2023. Together with a seismometer in Unterschleissheim, they cover the Karlsfeld East area More Information
Seismic monitoring plays a crucial role in the safety of geothermal plants. This technology permits real-time monitoring of vibrations in the ground. The seismic data collected also helps MTU safeguard the ongoing operation of the geothermal plant. The recorded data documents the ground vibration velocity. The data can also be used to determine the exact location of the source of the vibration.


MTU starts drilling for deep geothermal energy
Thermal water some two kilometers underground is set to largely replace MTU’s current gas-based heat supply
Munich, January 11, 2024 – MTU has begun drilling work in the northeastern corner of its Munich site, close to Dachauer Strasse. Following the traditional miners’ blessing from a local priest at the beginning of December and the safety inspections and performance tests, the actual drilling can now commence.
During drilling work, different signal tones will sound, water vapor will be released, and flames will appear as any escaping gas is flared. None of this poses any danger.
Traditional miners’ blessing
Munich, December 4, 2023 – On a freezing cold St. Barbara’s Day - St. Barbara being the patron saint of miners - MTU’s geothermal team, site management, representatives of the local authorities, the company works council, and guests from the supporting MTU divisions gathered by the geothermal drilling rig erected last week to witness a local priest bless the drill bit. “Here where we stand, you can see how we as a company are tackling climate change with regard to our infrastructure,” said Dr. Markus Zeis, Senior Vice President Enablement. “We’ve spent the past three years working on this geothermal project, which affirms our commitment to Munich as a location.” Geothermal energy is the biggest step on the way to making the site climate-neutral. The energy will be used to supply the site with emissions-free heat.
